The scheme made advanced construction commercially attractive to developers. As yesterday’s innovations become today’s baseline, what should the next incentive reward?

Three percent sounds small until someone draws it.

On a development with 100,000 square metres of permissible GFA, three percent represents another 3,000 square metres of floor area. It may not increase the allowable number of homes, and it remains subject to planning constraints and the overall bonus-GFA cap. Even so, it can create enough value to alter a project’s feasibility—and enough interest to bring a developer back to the meeting table.

This was the attraction of the Built Environment Transformation Gross Floor Area Incentive Scheme, better known as BET GFA. Introduced in November 2021, it allows qualifying private developments to receive up to 3% bonus GFA for achieving higher standards in digitalisation, construction productivity, sustainability and maintainability.

The Government offered developers something they understood well—additional development potential—in exchange for adopting methods that individual projects might not otherwise volunteer to fund.

The bargain was unusually direct. Developers would commit to Integrated Digital Delivery, productive construction methods such as PPVC or advanced prefabrication, prefabricated MEP systems, higher quality and stronger environmental performance. The additional GFA helped offset part of the design effort, coordination burden, capital cost and adoption risk. Transformation had acquired a line in the feasibility spreadsheet. This tends to improve its chances of being discussed.

BET has received less attention in recent years, particularly for Government Land Sales sites. This is not necessarily because the policy lost relevance. Many requirements that BET once incentivised have increasingly been incorporated into newer land-sale conditions. What was previously encouraged through additional GFA has gradually moved into the development baseline.

Private sites, including many collective-sale redevelopments, may still qualify under the present scheme, subject to planning approval and the overall bonus-GFA budget. But BET expires on 23 November 2026. As technical assessment and planning must begin well before then, its practical runway is shorter than the calendar suggests.

This may appear to be a narrow discussion about additional floor area. It is not. The more important question is what that floor area persuaded projects to do differently—and whether those behaviours will continue after the incentive disappears.

What BET was really designed to change

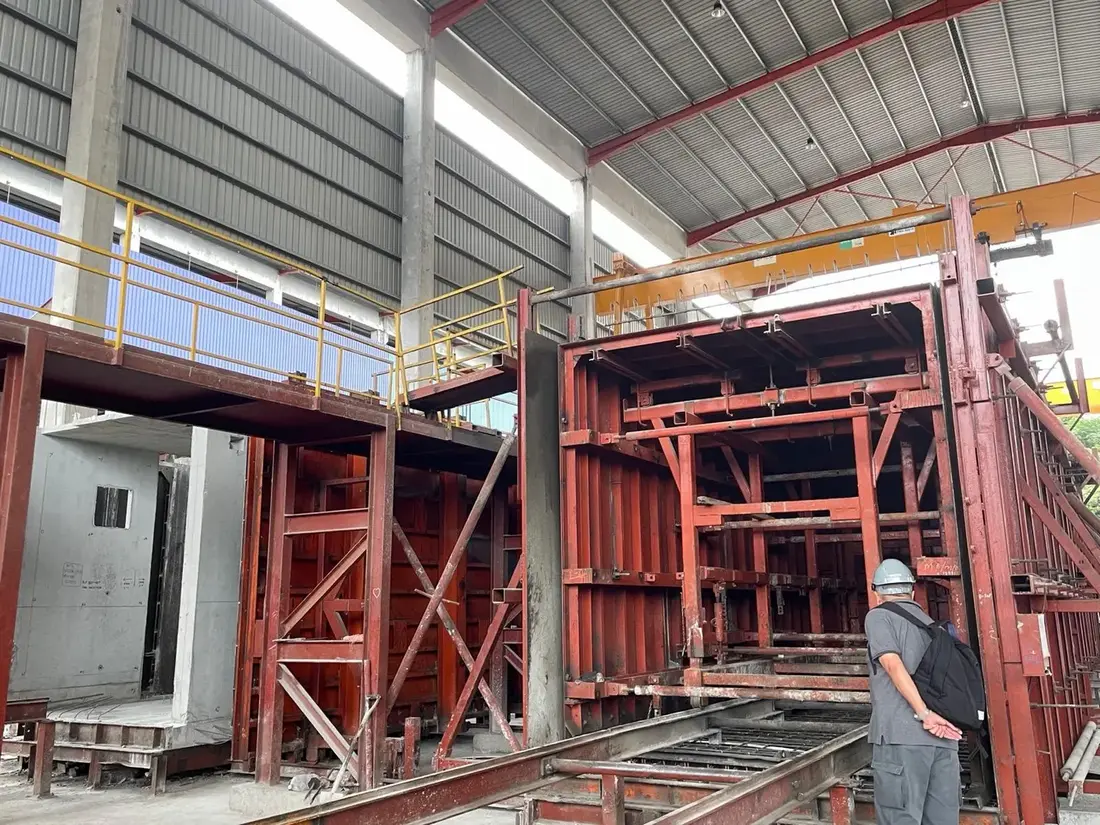

A steel mould for a PPVC module has little interest in the next drawing revision. Once fabrication begins, the apartment layout is no longer merely a design question. It has become a procurement commitment. The structural grid, façade interface, service openings, waterproofing details, tolerances and lifting points must already have been settled.

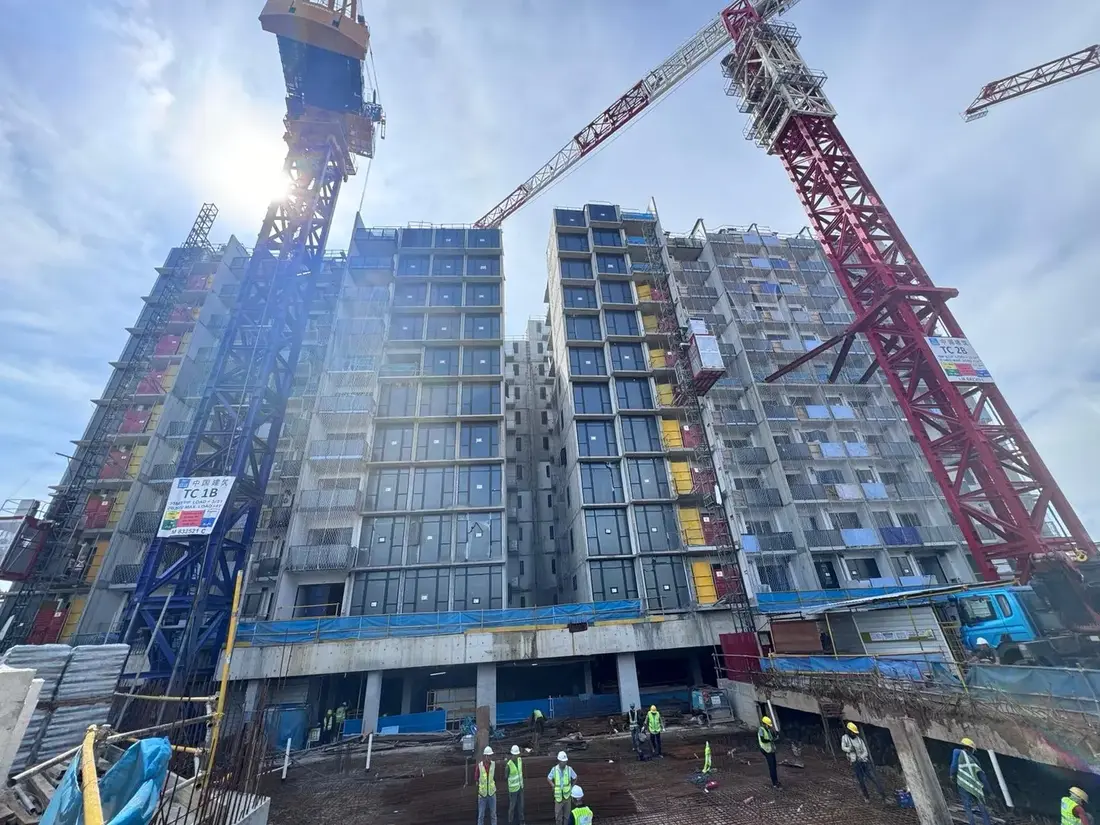

By the time several hundred modules enter production, “adjust on site” is no longer much of a strategy. Unresolved information does not remain quietly inside a drawing register. It gets manufactured, repeatedly and with impressive efficiency.

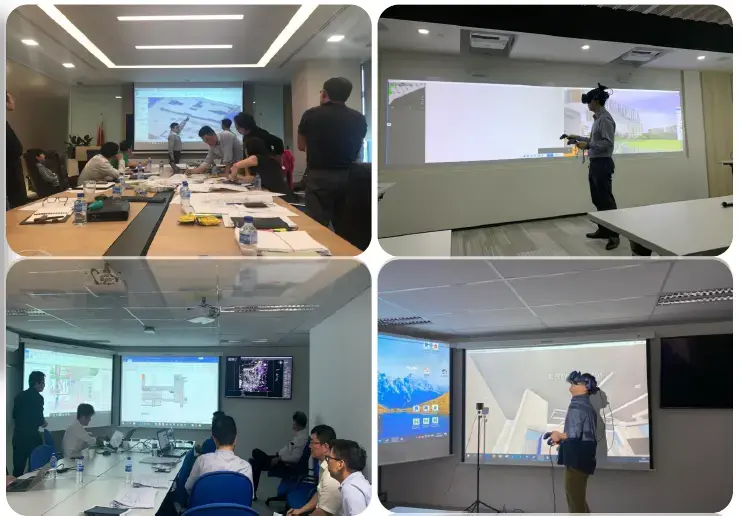

That is the discipline behind BET. The scheme did not merely encourage developers to purchase new technology. It required them to establish the conditions under which the technology could work: a clearer brief, earlier consultant coordination, sufficient design time, an aligned procurement strategy and construction knowledge brought into the room before important decisions became expensive to reverse.

Integrated Digital Delivery, PPVC, prefabricated MEP and Green Mark Platinum Super Low Energy may appear as separate qualifying requirements. On an actual project, they depend on the same discipline: early integration. PPVC cannot be introduced efficiently after apartment layouts and structural grids have been fixed. Prefabricated MEP achieves little if risers, ceiling zones, access panels and equipment clearances remain unresolved.

Higher energy performance becomes progressively more expensive once the building form, façade and plant strategy have been settled.

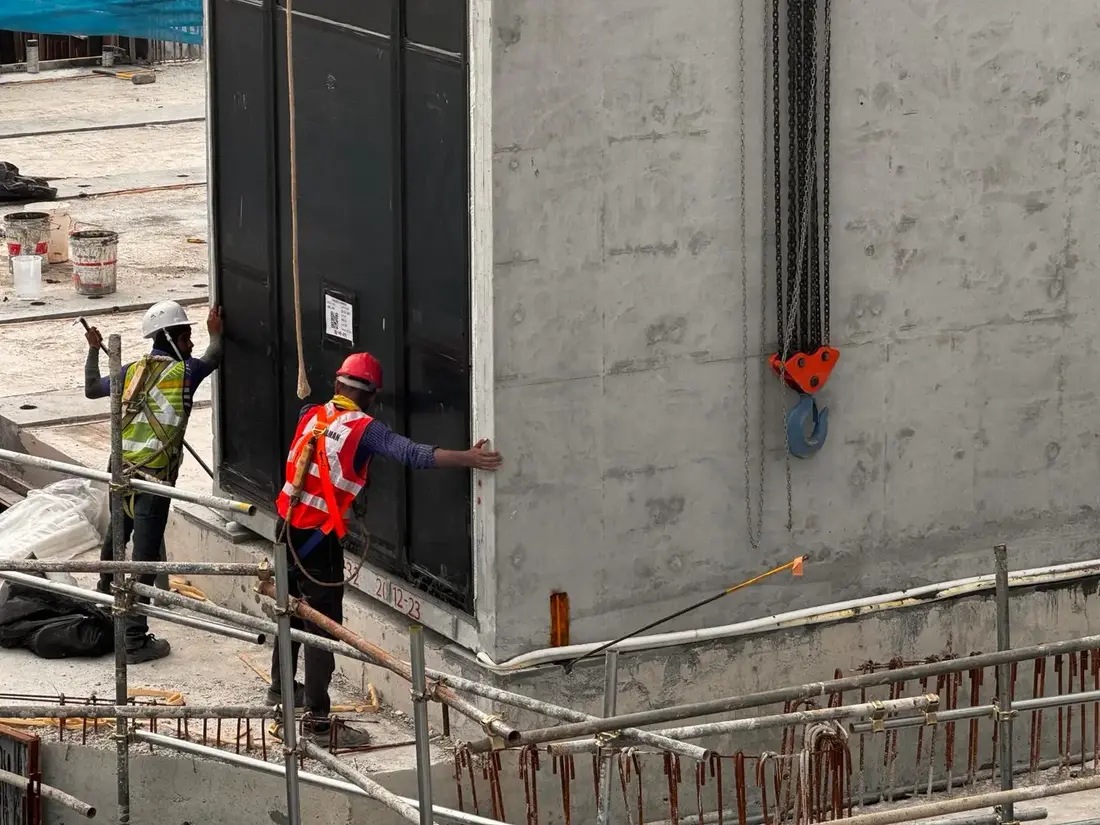

Quality also moves upstream. In conventional construction, a service opening can sometimes be enlarged, a pipe diverted or a finishing detail adjusted on site. With greater prefabrication, one poorly coordinated bathroom or façade detail can be reproduced across hundreds of units before the first problem is discovered. The factory does not cure incomplete information. It reproduces it more consistently.

BET therefore changed when projects had to make decisions. Developers establish the conditions; contractors execute within them. A contractor cannot recover during construction the coordination time that was never provided before tender.

The deeper bargain was limited additional development value in exchange for developer-led changes in how a project was planned, coordinated and manufactured. Much of the resulting value remained invisible: clashes that never reached the site, modules that avoided redesign, defects that were not repeated across 1,000 units and variations that never entered the final account.

Why expiry is defensible

A transformation incentive should not become a permanent reward for practices the industry already knows how to deliver. APCS, PPVC, prefabricated MEP and digital coordination are no longer unfamiliar ideas. Some have become part of GLS conditions, while CORENET X is pulling multidisciplinary coordination further forward. Sustainability expectations are also moving into the regulatory and commercial baseline.

Where a practice has become mandatory, widely adopted or part of ordinary procurement, the case for continuing to award valuable bonus GFA weakens. The incentive has then done part of its job. Continuing it unchanged would risk paying repeatedly for a transition that has already occurred.

There are legitimate planning considerations too. Additional GFA creates development value, but it may also add building bulk, population intensity and demand on transport and infrastructure. A temporary catalyst should not quietly mature into a permanent planning entitlement merely because everyone has grown accustomed to including it in the feasibility spreadsheet.

It is therefore reasonable to review whether BET’s present thresholds remain genuinely transformational and whether future support should reward verified outcomes rather than prescribed methods. Expiry would not necessarily mean the scheme failed. It may mean that its supported methods have moved closer to ordinary practice.

The question is whether the need for an upstream incentive has disappeared—or whether the frontier has simply moved beyond the current checklist.

What the present checklist may no longer catch

The next meaningful construction advance may not fit neatly within today’s definitions of APCS or PPVC. It could involve automated reinforcement production, robotic finishing, autonomous inspection, AI-assisted quality control, greater off-site completion or components designed for disassembly and reuse. A hybrid system may also fall short of a prescribed percentage while producing better results in manpower, quality, waste or embodied carbon.

These approaches face the same commercial problem BET was designed to address. The first projects carry the additional design work, integration burden, technical uncertainty and risk of failure. Later projects inherit the manufacturing capability, trained workforce, tested standards and lessons—usually at a lower price and with fewer surprises.

A developer may reasonably ask why one project should pay to prove a system that the rest of the industry will later acquire more cheaply. That is not necessarily resistance to innovation. It is an allocation-of-risk question with a fairly honest answer.

A successor to BET could therefore be smaller, more selective and technology-neutral. Rather than preserving the present checklist, it could support projects demonstrating measurable transformation beyond the prevailing baseline: material reductions in repetitive site labour, greater transfer of work into controlled manufacturing, better information continuity and verifiable improvements in quality, carbon, safety or maintainability.

The test should be the integrated outcome, not the number of technologies accumulated. Five digital use cases do not necessarily create an integrated project. Sometimes they simply create five use cases. A high PPVC percentage does not guarantee good prefabrication, just as a high environmental rating does not guarantee that the completed building will perform as intended—or that anyone will enjoy maintaining it.

Compliance can count activities. Transformation must improve the system.

Where en-bloc redevelopment fits

Collective-sale redevelopment deserves particular consideration, although being an en-bloc site should not create an automatic entitlement. Such projects inherit existing physical conditions rather than clean parcels structured around current requirements. There may be demolition constraints, legacy utilities, irregular boundaries, occupied surroundings and incomplete information about what lies below ground.

The replacement development must nevertheless meet current expectations for accessibility, sustainability, buildability, maintainability and productivity. Planning parameters, unit yield, structural grids, prefabrication, façades, MEP distribution and sustainability measures must all be reconciled before the project commits to a design that works commercially but resists efficient construction.

An upstream incentive can be especially useful here. It gives the developer both the discipline and a commercial reason to confront difficult coordination questions while they remain relatively inexpensive to resolve. En-bloc projects may therefore have more to gain from BET’s underlying principle, even if they should not receive bonus GFA merely because their sites are difficult.

Acquisition risk, demolition and inherited conditions remain part of the commercial decision to purchase an existing estate. A stronger incentive tier would be defensible only where genuine redevelopment complexity is combined with transformation outcomes materially above the prevailing baseline. It would recognise the harder task of integrating advanced systems into a constrained redevelopment, not reward the act of buying an old estate.

The distinction matters because anticipated bonus GFA may be capitalised into the collective-sale expectation before a consultant is appointed or a construction system considered. If the additional value is absorbed into the land price, little remains to support the transformation work it was meant to encourage.

The objection worth answering

The strongest objection to a technology-neutral scheme may come from the people required to administer it.

Their argument is reasonable. A percentage is auditable. PPVC content can be measured, a Green Mark rating verified and a common data environment inspected. “Materially better outcomes” cannot be checked against one table in a circular. Judgment-based assessment may invite inconsistent decisions, appeals and disputes over why one proposal qualifies while another does not.

Prescription is not necessarily a failure of imagination. It is often what makes an administrative decision consistent and defensible. A more flexible pathway may require an independent technical panel, published criteria, agreed performance indicators and post-completion verification, together with a credible mechanism to reduce or recover the incentive where commitments are not fulfilled.

This would be slower and more expensive than counting percentages. It could also favour sophisticated developers and consultants who are better at preparing persuasive submissions. Any successor must therefore ensure that a polished proposal does not outperform a productive system. Not every experiment deserves bonus GFA, and nobody needs another layer of paperwork wearing a more futuristic name.

There is also a commercial risk. If the incentive is treated as guaranteed development potential, sellers may price it into their expectations and developers may bid it away before deciding how it will be earned. A successor should be large enough to influence an upstream investment decision, but not so large that the land bid depends on receiving it.

An incentive that cannot say no eventually becomes a discount.

What should happen before November

The useful next step is neither a blanket extension nor silence. It is a published review of what BET has delivered over its five-year life: how many projects adopted it, what types of development used it, what the additional GFA cost in planning and infrastructure terms, and which measures required genuine changes to design, procurement and coordination.

The review should also examine completed outcomes. Did projects reduce site manpower, improve quality or provide better information continuity? Did sustainability measures deliver the expected operational performance? Which requirements changed developer behaviour, and which became compliance exercises that looked more transformational in the submission than on the project?

Five years should have produced a meaningful body of evidence. It would be a waste to let a calendar date substitute for reading it.

That evidence could support a smaller successor pathway focused on advances beyond the regulatory baseline. Its thresholds should move over time. Once a method becomes mandatory or widely established, it should cease to receive the same reward. Complex en-bloc projects could qualify for a stronger tier, but only where inherited constraints are real and the proposed outcomes correspondingly higher.

Planning capacity must remain a condition. Innovation cannot override height, traffic, infrastructure or environmental limitations. A productive construction method does not make an overloaded junction less busy.

For projects still considering BET, the runway is shorter than the November date suggests. The relevant development application must meet the deadline, while technical assessment and acceptance take time. November is the closing date, not the date to begin thinking about it.

Retain the principle, move the frontier

BET recognised something important about construction transformation. Innovation is not merely the arrival of a machine, platform or prefabricated component. It is the integration of planning, design, manufacturing, regulation and procurement early enough for that system to work.

That integration imposes cost and risk long before its benefits become visible. BET helped move PPVC, digital delivery, prefabricated MEP and higher environmental performance closer to ordinary practice. If those methods no longer require the same support, the scheme has done part of its job.

Practitioner takeawayThe next scheme should not keep buying what the industry already knows how to do. The frontier has moved. The policy should move with it.
